How to size, specify and deploy an industrial generator

How to size, specify and deploy an industrial generator

Industrial Generator Buying Guide: How to Size, Select, and Deploy High‑Capacity Power for Industrial Operations

Audience, intent, and promise

This guide is for plant managers, facility engineers, operations leaders, and procurement pros who need a dependable industrial generator for factories, mines, hospitals, data centres, water assets, and utilities. Your intent is to compare options, shortlist, and move to RFQ with confidence. You will get clear steps for sizing, a specification checklist, compliance pointers, and total cost of ownership framing.

References: (source) (source) (source)

Introduction: the problem and the solution

An industrial generator protects safety, production, and compliance when the grid fails. Unplanned loss of power can stop lines, endanger patients, corrupt data, or flood assets. Correct sizing and specification reduce downtime and improve total cost of ownership by matching capacity, transient response, and duty rating to your site. This guide shows how to pick the right large generator, compare fuel choices, and plan deployment so big generators run clean and reliable in Australian conditions.

References: (source) (source)

What is an industrial generator? Definition, scope, and industrial electric generator basics

An industrial generator is a heavy-duty, stationary power system designed to deliver three‑phase, high‑capacity electricity for long runtimes. It combines an engine (often diesel or natural gas), an alternator, and controls to convert mechanical energy into electrical energy. An industrial electric generator is the full engine‑alternator‑control assembly that delivers stable power under standby, prime, or continuous duty.

Industrial units differ from commercial or portable sets. They are built for higher duty cycles, big step loads, stronger alternators, advanced control logic, and compliance needs found in hospitals, mining, data centres, and utilities. Typical outputs run from about 200 kW to multi‑MW. Common three‑phase voltages include 415 V in Australia (low voltage), and medium‑voltage such as 11 kV and 13.8 kV for larger plants.

In simple terms: an industrial generator is the backbone source when the grid cannot meet your process needs or reliability targets. It is the plant’s safety net.

References: (source) (source)

Power rating fundamentals for a large generator: ISO 8528 and step loads

ISO 8528 defines the rating language you will see on a generator nameplate. Pick the right rating for your job to avoid overload, emissions issues, and early failure.

• Standby Power (ESP): For variable load during utility outages. Not for prime power. Limited annual hours. No overload capability.

• Prime Power (PRP): For varying load with unlimited hours per year. Up to 10% overload for limited time if the OEM allows, per ISO 8528.

• Continuous Power (COP): For constant load, unlimited hours. No overload.

Account for peak and surge loads. Motors can draw 3–7 times full‑load amps without soft start. Transformers have magnetising inrush. After an outage, a UPS can charge hard. You can use soft starters or VFDs to reduce kVA demand and keep voltage dip within limits.

One big unit vs paralleled sets: a single large generator is simple to run and maintain but has a single maintenance window. Multiple paralleled sets add flexibility, redundancy (N+1), and scalability, but switchgear is more complex and costs more.

Australian note: Always record the duty, ambient temperature, and altitude in the spec. Check OEM derating for Australian heat. Tie your design back to ISO 8528 and AS/NZS 3010 for installation.

References: (source) (source)

Where large generators and big generators are used: common industrial applications

• Process manufacturing: Many large motors and conveyors. High inrush. Product loss risk if power sags.

• Mining and oil & gas: Remote sites, variable loads, long runtimes. Dust, heat, and heavy duty. Fuel logistics are key.

• Data centres: N+1 or N+N designs with UPS and static transfer switches. Tight step‑load acceptance. Frequency stability matters.

• Water and wastewater: Critical pumps and aerators. Must ride through peak flow events and storms.

• Hospitals and healthcare: Life‑safety loads. Rapid start, defined by emergency power standards. Regular audits.

One large generator keeps distribution simpler and can reduce footprint. Multiple units in parallel add redundancy and let you match runtime to part‑loads for better fuel efficiency. Noise, maintenance windows, and site layout will guide your choice.

Australian scenarios:

• Remote QLD mine with summer ambient at 42°C needs derating and high‑capacity cooling.

• VIC food processor with strict cold chain uses a staged start to protect compressors and reduce voltage dip.

• NSW hospital must plan for weekly tests and 10‑second transfer for critical care areas.

References: (source)

Fuel choices for industrial operations: diesel industrial generators and alternatives

Diesel industrial generators dominate high‑capacity and mission‑critical use. They offer high energy density, strong transient response, and proven reliability. On‑site storage is straightforward with bunded tanks and spill containment. For many plants, a big diesel generator gives the best step‑load performance and fast recovery.

Emissions and compliance: Modern nonroad diesel engines use aftertreatment such as DOC, DPF, and SCR to meet strict tiers in many markets. Know your local air rules and permit limits. Aftertreatment needs correct low‑ash oils and regular checks.

Renewable diesel (HVO): Many engines can run on HVO with OEM approval. It can cut lifecycle CO2 and may improve cold‑flow. Always confirm seals and fuel system compatibility.

Alternatives:

• Natural gas: Lower local emissions and good for continuous runtime where pipeline reliability is high. Slower transient response than diesel.

• Bi‑fuel or dual‑fuel: Mix gas with a small diesel pilot for flexibility and fuel hedging.

Best practices for diesel generators industrial applications:

• Run a fuel quality program: sample for water, sediment, and microbes; polish and filter as needed.

• Use code‑compliant, double‑wall tanks with leak detection and spill containment.

• Plan for cold starts with heaters where needed; use additives in low temps.

• Protect fill points with lockable caps and overfill protection.

References: (source) (source)

Sizing and specification: step‑by‑step for an industrial generator or large generator

Step 1: Load inventory and profile

• List all loads with kW, voltage, phase, and starting method. Mark continuous vs intermittent.

• Calculate kVA from kW and power factor: kVA = kW / PF. Use realistic PF per load type.

• Group loads into start steps to manage inrush. Stagger large motors.

• Account for non‑linear loads (VFDs, UPS). Consider alternator upsizing and 2/3 pitch to limit THD and heating.

Step 2: Select rating by duty (ISO 8528)

• Standby vs Prime vs Continuous based on use case and annual hours.

• Data centre standby picks ESP with tight transient specs. Remote plant prime picks PRP with 10% overload if allowed.

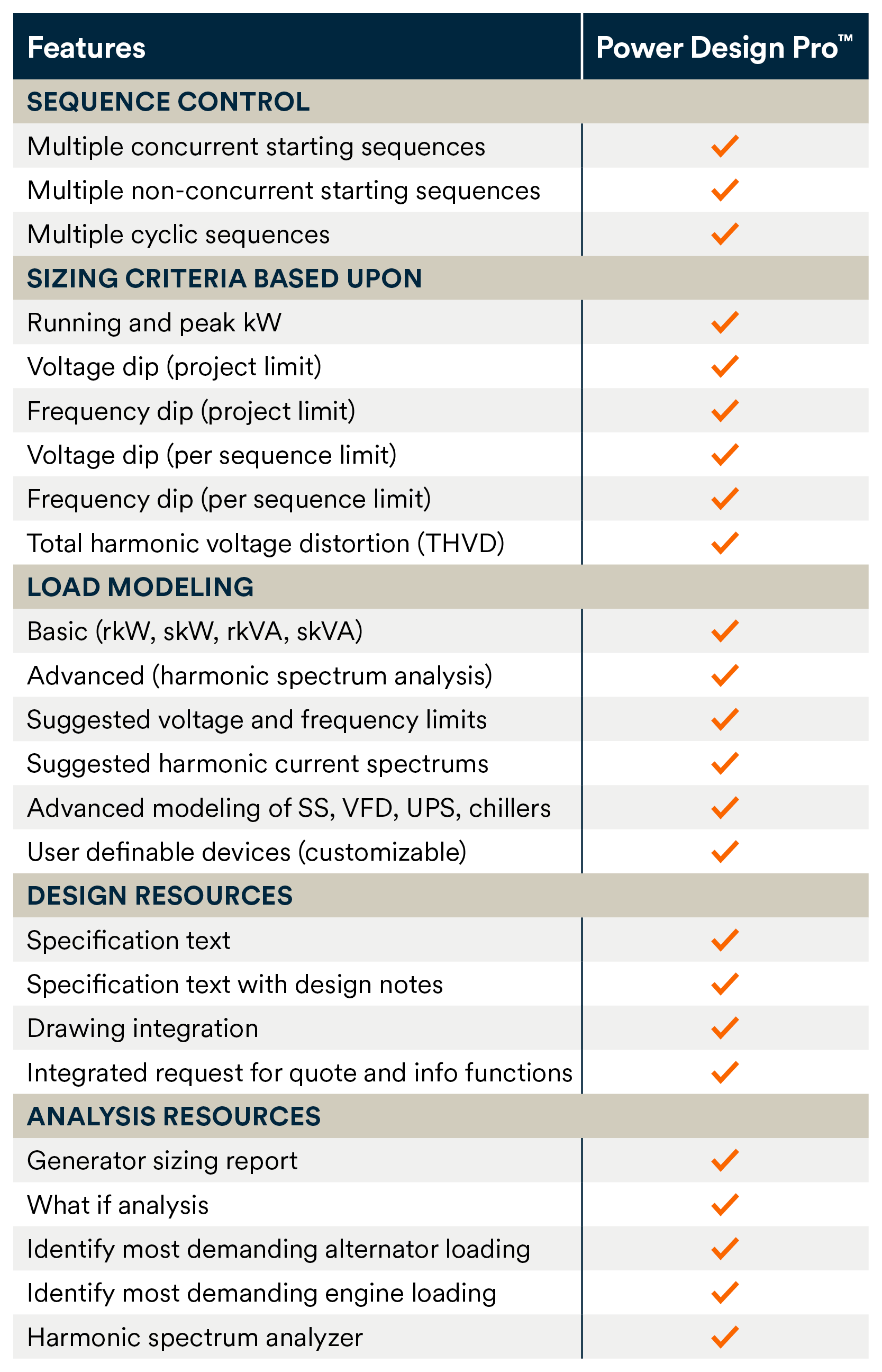

Step 3: Transient performance

• Set acceptable voltage dip (often 10–15%) and frequency dip (for example, 2–5 Hz) at first step load.

• Request OEM transient curves. Check UPS compatibility and generator mode settings.

Step 4: Site conditions and derating

• Record ambient temperature and altitude. Higher values reduce capacity; apply OEM derating.

• Consider enclosure derate and intake/exhaust limits.

Step 5: Redundancy strategy

• Single large unit for simplicity vs paralleled large generators for N+1 and scalability.

Step 6: Runtime and fuel storage

• Define minimum on‑site runtime for your risk profile and local rules. Size main and day tanks. Use double‑wall tanks, leak detection, and bunding.

Deliverables should include a one‑page load study, a one‑line diagram, duty rating justification, and environmental derating notes.

References: (source) (source) (source)

Key components and options to include in your RFQ for an industrial electric generator

Engine

• Displacement and cylinder count; turbocharging and aftercooling.

• Emissions aftertreatment (DOC/DPF/SCR) and required fluids.

• Jacket‑water and lube‑oil heaters for cold starts.

Alternator

• Sizing margin vs kW to support motor starting.

• Insulation class (Class H common), temperature rise, and IP rating.

• 2/3 pitch and AVR features for stable voltage and lower harmonics.

Controller and controls

• Auto‑mains failure (AMF), remote monitoring, event logging.

• Paralleling and synchronisation; SCADA support (Modbus, SNMP).

Power distribution and switching

• ATS type (open or closed‑transition), bypass/isolation ATS.

• Medium‑voltage switchgear, protective relays (ANSI functions), and ground fault coordination.

Enclosures and acoustics

• Weatherproof, sound‑attenuated, critical grade.

• Intake/exhaust silencers and corrosion resistance (C3/C5).

Integration and security

• SCADA/telemetry, remote fuel fill safeguards, and physical security.

References: (source)

Compliance, safety, and permitting for an industrial generator in Australia

Use recognised standards and engage your local authority having jurisdiction (AHJ).

• Australian standard: AS/NZS 3010 for electrical installations of generating sets. This guides safe connection, change‑over, earthing, and labelling.

• Electrical categories: Many sites separate emergency, legally required standby, and optional standby circuits. Coordinate switching and discrimination.

• Product safety: Look for recognised product listings and tested assemblies. In many markets UL 2200 is referenced for generator assemblies; in Australia, confirm equivalent certification and compliance with AS/NZS requirements.

• Emissions and air: Check local air permits and any run‑hour limits or stack height rules.

• Fuel and fire safety: Double‑wall tanks, overfill protection, secondary containment, separation distances, and venting.

• Records: Keep as‑builts, one‑line diagrams, protection settings, permits, maintenance logs, and test reports.

Helpful links: (source) (source)

Installation and commissioning best practices for a big diesel generator

Site preparation

• Design the concrete pad for weight and dynamic loads. Fit vibration isolators.

• Plan crane and rigging; confirm clearances. Install an effective earthing system.

Airflow and exhaust

• Meet OEM airflow. Avoid hot‑air recirculation.

• Route exhaust to keep backpressure within limits; consider vertical discharge above roofline.

Electrical integration

• Plan cable routes. Separate control and power to reduce EMI.

• Include MV transformer and gear if needed. Confirm short‑circuit ratings.

Fuel system

• Size the day tank. Provide leak detection, bunding, and polish loops.

• Design fill and vent piping for safe refuelling.

Commissioning and testing

• Do factory and site tests. Load bank to verify kW, kVAR, voltage regulation, and transient response.

• Function‑test ATS and switchgear. Validate alarms and shutdowns.

Utility coordination

• For closed‑transition or utility paralleling, agree protection settings and anti‑islanding with the DNSP.

Australian note: Engage a licensed electrician and follow AS/NZS 3010 for change‑over and earthing. In hot regions, confirm enclosure derate and oversize ventilation where needed.

References: (source)

Maintenance and reliability engineering for diesel industrial generators

Preventive maintenance

• Service oil and filters by hours and calendar. Check coolant chemistry and replace per OEM.

• Inspect belts, hoses, and air filters. Use delta‑P indicators to guide changes.

Batteries and starting system

• Test batteries and replace as needed. Keep chargers healthy. Use jacket‑water heaters to ensure quick starts.

Fuel quality

• Sample for water, particulate, and microbes. Polish and clean tanks on a schedule.

Exercising and load banking

• Exercise under load to avoid wet stacking. If site load is low, do annual load‑bank tests.

Service level agreements

• Define response times, spare parts kit, and remote monitoring. Track MTBF and MTTR.

Practical tip: We have seen voltage dip resolved by upsizing the alternator and sequencing VFD starts. Quarterly load‑banking also cleared wet stacking on a standby set at a suburban Melbourne clinic.

References: (source)

Cost and procurement: TCO for an industrial generator, large generator options, and big generators

CAPEX vs OPEX

• CAPEX: Generator set, ATS/switchgear, enclosure, installation, permits.

• OPEX: Fuel, fluids and filters, aftertreatment service, testing, parts, monitoring, and overhauls.

Fuel consumption curves

• Request OEM fuel maps. Estimate annual fuel cost: kWh per year × litres per kWh × price per litre. Use your load profile by hour.

10–20 year TCO

• Compare a single unit vs paralleled sets. Compare diesel vs gas. Use NPV to include uptime penalties and maintenance.

Bid comparison and risk

• Score lead time, warranty length, local service depth, availability of rental bridge, telemetry stack, and emissions inclusions.

Example bid matrix headings

• Rating, voltage, transient spec, enclosure dB(A), fuel run‑hours, emissions tier, price, lead time, warranty, service coverage.

References: (source)

Case studies and scenarios: applying a big diesel generator and paralleled large generators

Manufacturing plant: 1.5 MW big diesel generator

• Load profile: Multiple 250–400 HP motors, mix of VFD and across‑the‑line starts.

• Design: Step‑load plan to hold voltage dip ≤15%. Alternator sized for inrush and THD limits.

• Outcome: Met transient targets. 24‑hour fuel autonomy using a day tank and scheduled top‑off. Scrap reduced during outages.

Data centre: paralleled sets (3 × 1000 kW) for N+1

• Coordination: UPS and STS tuned to generator frequency stability. Closed‑transition ATS for monthly tests.

• Outcome: Improved availability, scalable capacity, and easier maintenance windows under live load.

Compliance note: Tie projects to AS/NZS 3010 for installation. Where US frameworks are referenced for design intent, align to NFPA 110 concepts (Type 10 start and fuel Class), and ensure product safety certification comparable to UL 2200. Secure local emissions permits before commissioning.

References: (source)

Vendor/RFQ checklist: copy‑paste items for an industrial generator, large generator, and diesel industrial generators

Technical

• ISO 8528 rating, kW/kVA, voltage, ambient and altitude, step‑load acceptance, voltage/frequency dip, THD, alternator pitch, temperature rise, insulation class, enclosure type, and dB(A).

Engine and emissions

• OEM and model, aftertreatment details, tier certification, fuel maps, fluids spec, and cold‑weather kit.

Electrical and controls

• Controller features, remote monitoring protocols, protection relays, ATS/gear type, short‑circuit ratings, and grounding scheme.

Fuel and mechanical

• Main and day tank sizes, spill containment, polishing, piping, ventilation, and exhaust backpressure.

Compliance and documentation

• AS/NZS 3010 scope, local permits, as‑builts, testing protocols, O&M manuals, warranty, and service plan. Include any UL 2200 equivalence notes if required by the client.

Services

• Commissioning scope, training, spare parts kit, SLA response, and rental bridge options.

FAQs

What size industrial generator do I need for a X kW load?

Start with total running kW. Convert to kVA using kVA = kW / PF. Add starting kVA for motors (often 3–7× FLA without soft start). Group step loads. Choose ISO 8528 rating by duty and apply altitude and ambient derating. Verify with OEM transient curves for your large generator.

References: (source) (source)

Diesel vs natural gas for transient response in industrial electric generator applications?

Diesel typically gives faster transient response and better step‑load acceptance. Gas can be preferred for continuous runtime and lower local emissions where pipeline reliability is high. Always confirm site gas reliability and UPS compatibility before you decide.

References: (source)

How many large generators to parallel for N+1 redundancy?

Size each unit to carry the N portion of the critical load. Add one extra unit for N+1. Balance footprint, fuel logistics, and switchgear complexity when choosing between one large generator and multiple paralleled units.

References: (source)

What permits are needed for diesel industrial generators?

Expect local air permits, fuel storage and fire approvals, and electrical inspections. Keep installation aligned to AS/NZS 3010 and hold product and testing documents ready. If your client requests US references, have UL 2200 and NFPA 110 equivalence notes on file.

Best practices for diesel generators industrial deployments

Maintain fuel quality with testing and polishing. Follow a PM plan for oil, coolant, and filters. Exercise with load or load‑bank annually. Check aftertreatment health on Tier 4 style systems to avoid faults. These steps protect a big diesel generator from wet stacking and poor starts.

References: (source) (source)

Is AS/NZS 3010 required for generator installation in Australia?

Yes. AS/NZS 3010 sets the rules for generator installations, including change‑over, earthing, and labelling. A licensed electrician should ensure compliance for any industrial generator project.

Helpful links: (source)

Closing: bring it all together

Choosing the right industrial generator is about facts, not guesswork. Build a clear load profile. Select an ISO 8528 duty rating. Decide on diesel or gas with eyes on transient response, emissions, and runtime. Engineer the installation to AS/NZS 3010. Plan maintenance, fuel quality, and testing so the system performs when it counts. With a solid spec and lifecycle plan, a large generator will keep your site safe, productive, and compliant across Australian conditions.

References: (source) (source) (source)

• Alt text suggestion: Industrial generator sizing one‑line diagram.

• Alt text suggestion: Large generator installation airflow diagram.

• Alt text suggestion: Fuel storage layout for a big diesel generator.

• Alt text suggestion: Bid comparison matrix for large generators.

FAQ

• What size industrial generator do I need for a X kW load?

• Diesel vs natural gas for transient response in industrial electric generator applications?

• How many large generators to parallel for N+1 redundancy?

• What permits are needed for diesel industrial generators?

• Best practices for diesel generators industrial deployments

• Is AS/NZS 3010 required for generator installation in Australia?

Disclaimer: The information provided in this article is for general guidance only and does not constitute professional advice. Generator sizing, installation, and electrical connections should always be assessed by a qualified professional. We strongly recommend consulting a licensed electrician or electrical contractor to ensure all systems are compliant with Australian Standards and suitable for your specific use case. Mick’s Gone Bush accepts no liability for any decisions made based on the information provided.
