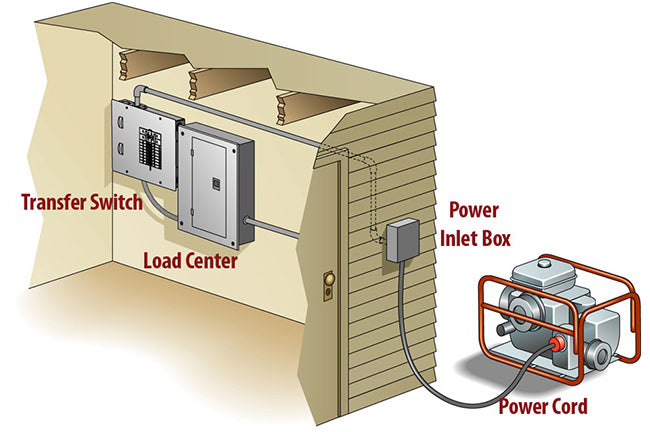

Automatic Transfer Switch Selection and Installation Guide
Automatic Transfer Switch: How to Select, Size, Wire & Install the Right ATS for Your Generator
Introduction
An automatic transfer switch (ATS) is a microprocessor-controlled switching device that shifts power from the utility to a standby generator the instant it senses an outage, then returns to the grid once it is stable (Source). The cost of downtime can vary widely, from moderate inconvenience in homes to significant financial impacts in hospitals and data centres, where outages can average up to US$740,000 (Source). This post covers the technical aspects of ATSs, including how to choose the right type, features to look for, wiring details, and installation insights.
How an Automatic Transfer Switch Works
An automatic transfer switch serves as a critical link between your power sources. Here's the functional sequence: (1) Source sensing continuously monitors primary power, (2) If an outage occurs, it sends an engine start signal to the generator, (3) The transfer mechanism switches to generator power using two mechanically interlocked contact sets metered to UL 1008 for 3-cycle withstand, and (4) The system automatically reverts to grid power when it stabilizes, followed by a generator cool-down period (Source).
Main components include solenoid or servo actuators, voltage and frequency sensors, logic controllers, and manual bypass options, forming the core of an ATS’s operation (Source).
Why You Need an ATS: Real-World Reliability Cases
An ATS is indispensable in critical operations. In healthcare, NFPA 99 mandates a maximum 10-second switch for essential circuits (Source). Data centres must uphold a Tier III requirement, requiring 72-hour fuel supply with redundant ATS pathways. In manufacturing, ATS maintains continuous processes to prevent expensive stoppages. While a manual changeover switch might suffice in non-critical settings, such as off-grid cabins or farm irrigation, the automatic feature of an ATS ensures reliability in systems where even brief outages could prove disastrous.
ATS vs Manual Changeover Switch
The decision between an automatic transfer switch and a manual changeover switch often depends on load criticality and budget. Consider the table below for a concise comparison:
| Aspect | ATS | Manual Switch |
|---|---|---|
| Human Intervention | None | Required |
| Transfer Speed | 0-3 sec | 30-120 sec |
| Cost | Higher | Lower |
| Complexity | Complex | Simple |
| Safety (Back-feed Risk) | Low | Higher |
| Typical Amp Ratings | 50 A to 4000 A | 60 A to 200 A |
An ATS complies with UL 1008 standards, offering reliability not available in manual alternatives, often rated per UL 98/508.
Single-Phase Transfer Switch vs Three-Phase ATS
A single-phase transfer switch is suitable for residential settings, handling 120/240V loads, whereas three-phase ATSs cater to larger applications, such as commercial and industrial setups demanding higher capacities (Source). The need to upgrade from a single-phase switch arises when powering substantial equipment or exceeding 20 kW of service. Three-phase systems ensure balanced power distribution with three hot wires, a neutral, and a ground, requiring more space than the two hot wires in single-phase applications.
Key Modern Features to Look For
Load Sensing ATS
Load sensing ATSs detect and respond to fluctuations, minimising back feed and optimising load distribution (Source). These systems adapt by measuring RMS current and voltage each cycle, preventing disruptions.
Smart ATS Controller
Smart ATSs integrate with facility management systems via Modbus/TCP, SNMP traps, and can deliver updates via email or SMS alerts. Advanced versions allow for remote firmware updates and provide user interfaces for controls and diagnostics, commonly cited in Eaton and ASCO data.
Mechanical Bypass-Isolation & Serviceability
This feature allows crucial testing and maintenance without interrupting the load, essential to keeping the ATS dependable in mission-critical setups.
Sizing an ATS Correctly
An ATS must match the generator’s specifications for optimal function. Here's a step-by-step guide to calculating the correct size:
• Determine generator standby rating in kW.
• For three-phase, convert to amps using I = kW × 1000 / (√3 × V × PF); for single-phase, use I = kW × 1000 / (V × PF).
• Select an ATS with a continuous current rating ≥ 125% of calculated current, per NEC Art 702.
• Ensure short-circuit withstand/closing rating meets available fault current (Source).
Consider oversizing, but never undersize. Environment conditions, such as temperatures surpassing 40°C, may require derating.
Selecting the Best ATS for a Home Generator
When selecting an ATS for home use, consider service entrance ratings, number of circuits, enclosure type, integrated load management, and compatibility with smart controls. Popular brands like Generac and ASCO offer valuable options for residential needs, with prices starting around USD 550 for a 150 A SE ATS. Always consider professional installation due to local regulatory demands and technical challenges.
Wiring & Installation Guide
Part A – Reading an ATS Wiring Diagram
Understanding ATS diagrams is key to safe installation. Diagrams typically showcase utility and generator input terminals and load connections. Proper interpretation ensures all safety interlocks and grounding measures are accurately implemented. Here’s an example of what you might encounter:
------------------------------ | UT | GEN | LOAD | ------------------------------ | | -- | ------------------------------ Part B – Step-by-Step Installation Overview (For a Licensed Electrician)
• De-energize the service; apply lock-out-tag-out processes.
• Mount the ATS enclosure, maintaining the recommended 3 ft clearance (NEC 110.26).
• Pull conductors, ensuring sizes meet NEC Table 310.16 guidelines.
• Separate neutrals and grounds on designated bars in SE ATS.
• Program delay-on-make and re-transfer times.
• Conduct an acceptance test simulating utility failure and measure voltage drop.
Part C – ATS Safety Requirements
Conforming to IEC and NEC standards is essential for ATS installations. Ensure interlocked contacts prevent backfeed and that proper surge protections are in place. Remote E-stop proximity is also critical for systems like Source.
Cost Breakdown & Budgeting
ATS installation expenses are influenced by service requirements, such as conductor sizes and installation environments. Residential systems range from US$500–900, while commercial systems can exceed US$3,000 hardware and US$4,000–8,000 in labor. SCADA integration and additional permits increase overall costs further. Consider the ROI of power continuity versus potential outage losses.
Testing, Maintenance & Compliance
Regular maintenance and compliance testing ensure ATS reliability. This includes monthly no-load and annual full-load bank tests and visual inspections. Adhere to documentation standards for ISO 9001 compliance and local authority requirements.
Quick-Reference ATS Selection Checklist
• Voltage and Amp ratings
• Single vs. Three-phase system
• Smart controller features
• Enclosure options
• Safety compliance
• Installation cost and complexity
Conclusion & Next Steps
Choosing the right automatic transfer switch involves balancing correct sizing, operational safety, and installation expertise. Consulting professionals ensures the system aligns with your electrical needs and regional codes, enhancing the longevity and reliability of your generator setup.
FAQs
• What is an automatic transfer switch (ATS)?
An ATS is a device that automatically switches power from a utility to a generator during an outage.
• Why is an ATS preferred over a manual changeover switch?
ATS reduces human intervention and provides faster, more reliable power transition.
• How do I size an ATS correctly?
Ensure the ATS continuous rating is at least 125% of the generator's operational amperage.
• What key features should I look for in a smart ATS?
Remote monitoring, compatibility with management systems, and advanced diagnostics are essential.
• Can I install an ATS myself?
DIY installation is not recommended due to complexity and legal compliance requirements.
• How often should ATS maintenance occur?
Conduct monthly no-load tests and an annual full-load bank test to ensure functionality.
About the Author
Micks Gone Bush, holds a Certificate III in Electronics and has over 15 years of experience delivering power solutions for off-grid, rural, and industrial applications.
